How to Make a Sprint Burndown Chart in Excel

How to Make a Sprint Burndown Chart in Excel

A burndown chart is a tool from Agile, where all the “Stories” or items of work to be completed in a given iteration (a two-week time frame), with their accumulated points (how small or large each story is) are shown on a chart as the points are completed, from their total at the beginning to zero at the end of the iteration.

This video and article shows how to make a sprint burndown chart in Excel. Enjoy!

Step 1

First add the general framing and colours to your sheet:

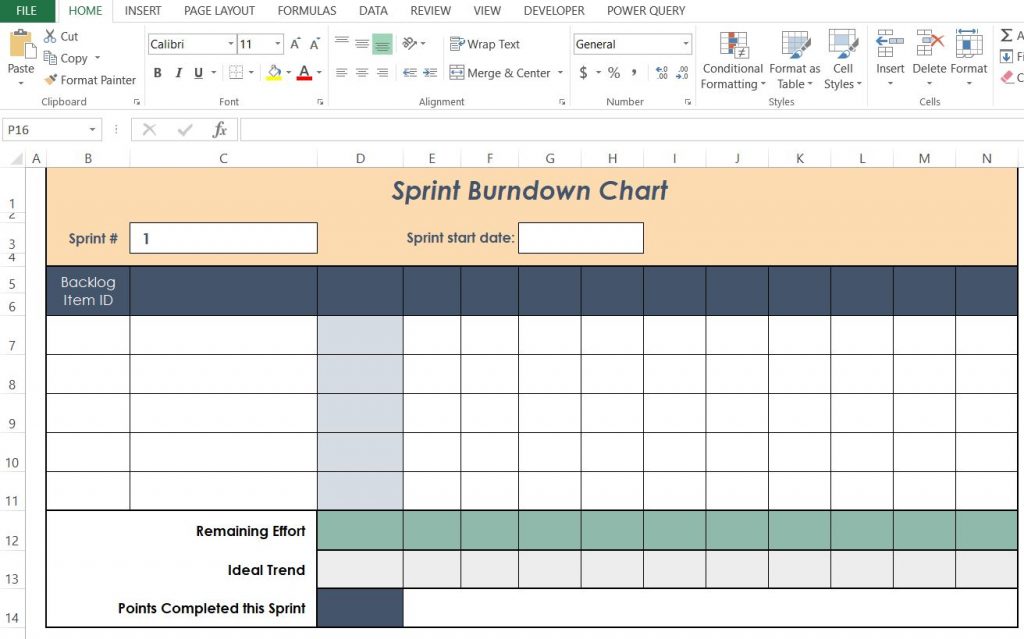

Sprint Burndown Chart in Excel 02

Step 2

Next, fill out the backlog IDs, feature or story names, dates, and points as necessary.

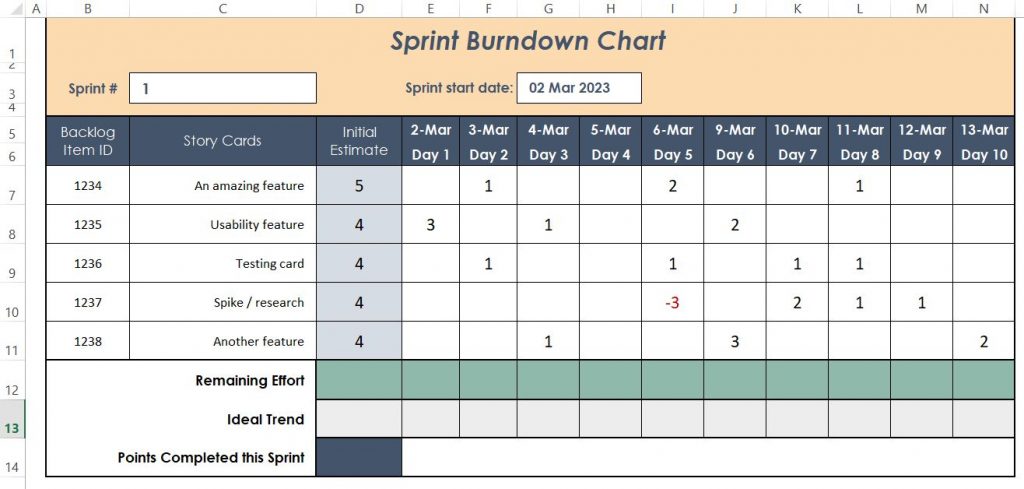

Sprint Burndown Chart in Excel 03

Step 3

Now we can add in the formulas for Remaining Effort, Ideal Trend, and Points Completed This Sprint:

  • Remaining Effort: First =SUM(D7:D18), then =D19-SUM(E7:E18)
  • Ideal Trend: =D20-($D$20/COUNT($E$5:$N$5))
  • Points Completed This Sprint: =SUMIF(E7:N11,”> 0″)

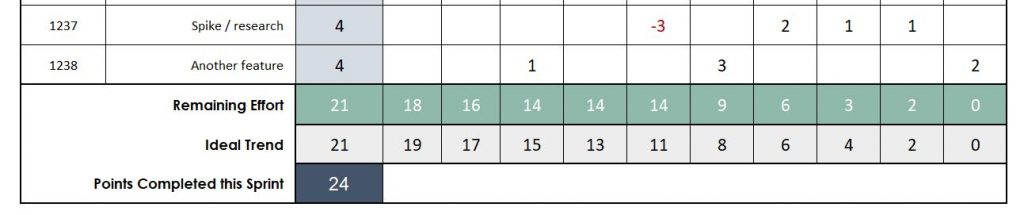

Sprint Burndown Chart in Excel 04

Step 4

Now we can create the burndown chart. Select Remaining Effort and Ideal Trend rows, go to Insert > Line chart.

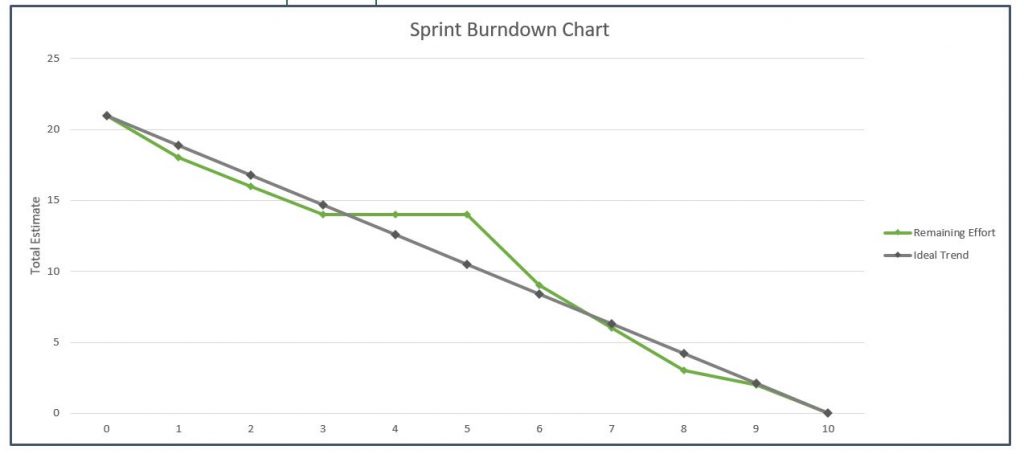

Sprint Burndown Chart in Excel 05

And now you have a beautiful sprint burndown chart in Excel!

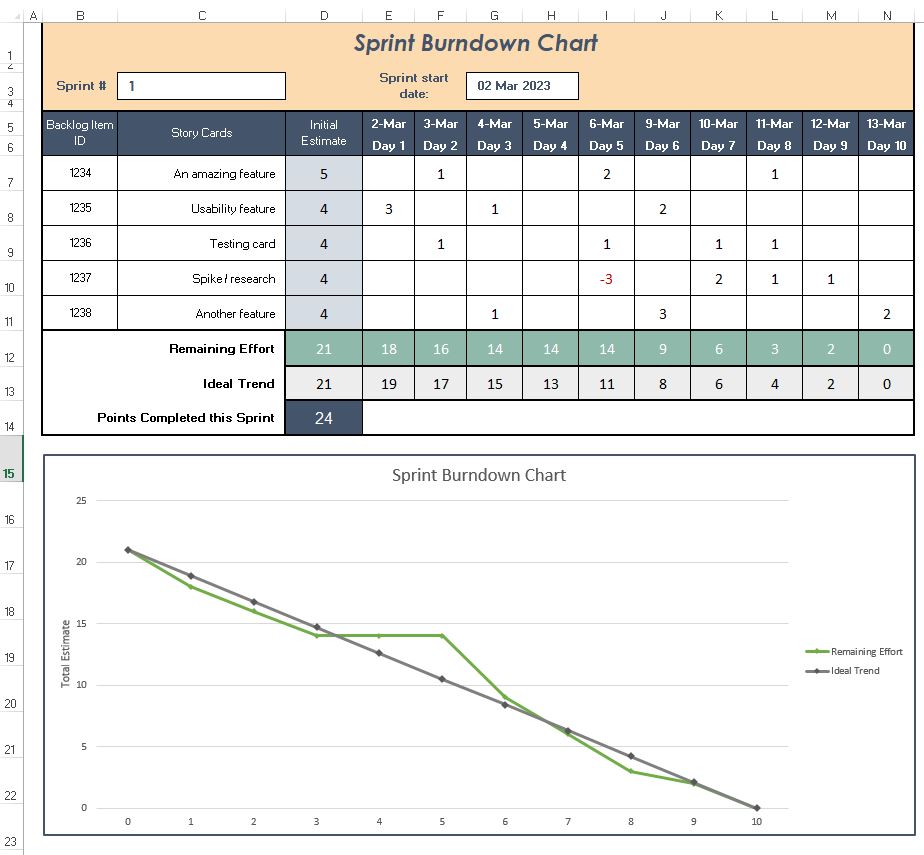

Sprint Burndown Chart in Excel 01
